You'd be surprised how often a Boston construction site gets shut down because someone skipped the ground improvement study. The fill is loose, the water table is high, and the excavator hits refusal six feet down. That's exactly the problem we solve with vibrocompaction design. Our team models the vibratory probe spacing and energy needed to densify the ground before you pour a foundation. Boston's geology includes extensive artificial fill from the 19th century — the Back Bay and South Boston were literally created by filling tidal flats with gravel, sand, and debris. Without proper stone columns or vibro techniques, that fill settles unevenly and creates differential movement across the slab. If the site is in a lower-lying area near the Charles River, we often recommend complementary liquefaction assessment to confirm the seismic demand on the treated ground.

Boston's 19th-century fill can settle three inches in a decade if you don't densify it first — vibrocompaction design makes that settlement negligible before the structure goes up.

Process and scope

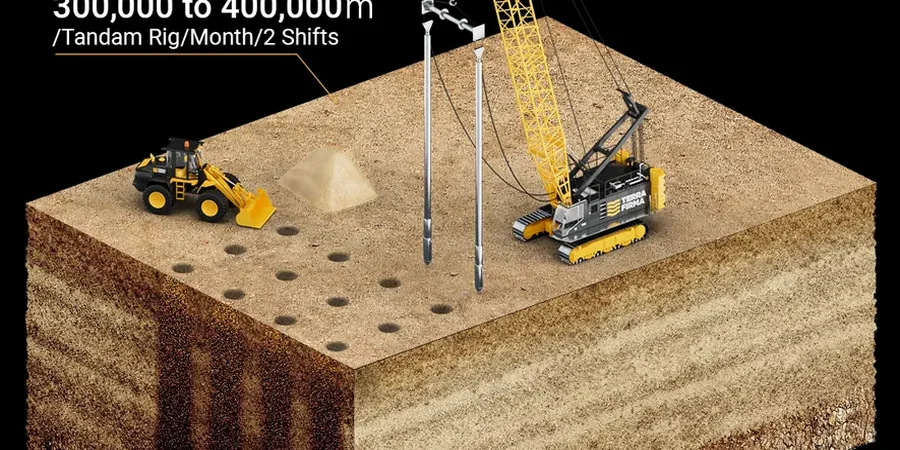

The equipment we specify for Boston jobs is typically a V23 or V32 vibrator hanging from a crane with 130-180 kW of power and a water flushing system. The probe penetrates under its own weight plus vibration, and we monitor the ammeter closely — when the current draw drops, the sand has reached refusal density. In Beacon Hill or Back Bay sites with buried timber piles and granite rubble, the vibrator needs a pre-augering stage to get through obstructions. Our design specifies grid spacing, usually triangular patterns at 5 to 9 feet, based on the target relative density from the CPT test data. We also integrate SPT drilling results to calibrate the energy correlation. For projects near Logan Airport where FAA settlement tolerances are tight, we add post-treatment verification with cone penetration testing at every fourth compaction point. The whole sequence — probe, compact, step back, repeat — runs in passes until the target depth is reached and the post-treatment CPT confirms the improvement ratio.
Vibrocompaction Design in Boston: Fill and Loose Sand Ground Improvement
Technical reference image — Boston

Site-specific factors

In Boston we often see that the fill layer is thicker than the geotech report suggests — sometimes fourteen feet of loose silty sand where the client expected six. That discrepancy changes the compaction depth, the probe type, and the cycle time on site. Another local issue is the old timber pile foundations that still sit under demolished buildings in the Seaport District and North End. A vibrator hitting a buried timber mat at 40 Hz can damage the probe and delay the project three days. We map those hazards with historical Sanborn fire insurance overlays before designing the grid. If the fines content exceeds 15%, standard vibrocompaction loses efficiency; in those cases we shift the design toward a combined approach with grouting or stone columns to ensure the target stiffness is met. Skimping on the pre-design site characterization is the single most expensive shortcut a developer can take in Boston — the cost of re-mobilizing a rig and re-compacting after foundation problems dwarfs the initial geotech investment.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnical-engineering.vip

Technical data

ParameterTypical value
Vibrator power range130 – 180 kW (V23/V32 typical)
Grid patternTriangular, 5–9 ft spacing
Target relative density70–85% (per project spec)
Depth capabilityUp to 65 ft in loose sand
Post-treatment verificationCPT at every 4th compaction point
Flushing water pressure60–120 psi (jetting assist)
Settlement reduction target≤ 0.5 inch post-treatment differential

Complementary services

01

Compaction Grid Design

We determine probe type, spacing, depth, and energy input per point based on CPT and SPT data. Grids are optimized for Boston's typical fill and sand profiles, with access constraints considered for tight urban lots.

02

Pre-Treatment Site Characterization

Cone penetration testing and SPT borings to map the loose zones, define the treatment depth, and identify obstructions like timber piles or buried foundations common in Boston's older neighborhoods.

03

Field QA/QC Supervision

Our engineer monitors ammeter records, probe penetration rate, and flushing pressure during compaction. We adjust the design in real time if subsurface conditions differ from the baseline report.

04

Post-Treatment Verification

CPT soundings at the center of selected compaction triangles to confirm the achieved relative density. We issue a signed verification report with acceptance criteria per the project specification.

Relevant standards

ASTM D1586-18 Standard Test Method for Standard Penetration Test (SPT) and Split-Barrel Sampling of Soils, ASTM D2487-17 Standard Practice for Classification of Soils for Engineering Purposes (Unified Soil Classification System), ASCE 7-22 Minimum Design Loads and Associated Criteria for Buildings and Other Structures (Chapter 20 liquefaction), IBC 2021 Section 1805 Dampproofing and Waterproofing (ground improvement acceptance criteria)

Questions and answers

What does vibrocompaction design cost for a typical Boston site?

For a standard single-lot job in the Boston area, the vibrocompaction design package — including pre-treatment CPT data review, grid layout, specification writing, and post-treatment verification report — runs between US$1,520 and US$5,240 depending on the treatment area and depth. Larger multi-building developments with complex fill profiles fall at the upper end of that range.

How long does the design phase take before the contractor can mobilize?

With existing CPT and SPT data in hand, we turn around the compaction grid and spec in four to six business days. If we need to arrange the pre-treatment testing first, add a week for field work and lab classification. Boston's permitting doesn't usually hold up a vibrocompaction design unless the site is in a historic district with vibration monitoring requirements.

Can vibrocompaction work next to existing buildings in Boston?

Yes, but it requires a vibration monitoring plan and a careful review of adjacent foundation types. We set peak particle velocity limits — typically 0.5 in/sec for unreinforced masonry on Beacon Hill, 1.0 in/sec for modern concrete structures — and specify the compaction sequence to push the vibrator away from the sensitive structure. Pre-condition surveys of neighboring properties are standard practice in our Boston projects.
